Skip to main content

Check out Port for yourself ➜

Measure sprint health with Jira

This guide walks you through measuring and visualizing sprint health at the team level. You will learn how to ingest sprint data from Jira issues, define sprint health metrics like completion rate and scope change, roll those metrics up to teams using aggregation properties, build trend visualizations, and enforce maturity standards with a scorecard.

Common use cases

  • Track delivery predictability: Measure how consistently teams complete planned sprint work.
  • Detect scope creep: Surface teams where mid-sprint additions are undermining planning.
  • Reduce carryover: Identify teams that routinely carry unfinished work into the next sprint.
  • Drive continuous improvement: Use maturity levels to encourage teams toward healthier sprint practices.

Prerequisites

Understanding sprint health metrics

Before configuring Port, let's define the three metrics that form the foundation of sprint health measurement:

MetricWhat it measuresFormula
Completion ratePercentage of sprint-committed issues that were resolved by sprint end.(issues done in sprint / total issues in sprint) × 100
Scope change %Percentage of issues added to the sprint after it started.(issues added mid-sprint / total issues in sprint) × 100
Carryover ratePercentage of issues carried from the previous sprint without being completed.(unresolved issues from prior sprint / total issues in sprint) × 100

A healthy sprint typically shows a high completion rate (>90%), low scope change (<10%), and low carryover (<10%).

Set up data model

We will extend the Jira issue blueprint with sprint-related fields and then add aggregation properties to the _team blueprint to roll up sprint health metrics.

Extend the Jira issue blueprint

Add properties that capture sprint context for each issue. These fields let us distinguish between issues that were planned, added mid-sprint, or carried over.

  1. Go to your Builder page.

  2. Search for the Jira Issue blueprint and click on it.

  3. Click on the ... button in the top right corner, and choose {...} Edit JSON.

  4. Merge the following properties into the properties object of your existing blueprint:

    Sprint health properties for Jira issue (click to expand)
    "sprint": {
    "title": "Sprint",
    "type": "string",
    "description": "The name of the current or most recent sprint for this issue"
    },
    "sprintState": {
    "title": "Sprint State",
    "type": "string",
    "enum": ["active", "closed", "future"],
    "description": "Whether the sprint is active, closed, or planned"
    },
    "storyPoints": {
    "title": "Story Points",
    "type": "number",
    "description": "The estimated effort for this issue"
    },
    "addedMidSprint": {
    "title": "Added Mid-Sprint",
    "type": "boolean",
    "description": "Whether this issue was added after the sprint started"
    },
    "carriedOver": {
    "title": "Carried Over",
    "type": "boolean",
    "description": "Whether this issue was carried from a previous sprint"
    }
  5. Click Save to update the blueprint.

Add a team relation to Jira issues

To roll up sprint metrics per team, we need a relation from Jira Issue to the _team blueprint. If your issues already have a team relation (for example, via the assignee's team), you can skip this step.

  1. In the Jira Issue blueprint, click on the ... button in the top right corner, and choose {...} Edit JSON.

  2. Add the following to the relations object:

    "team": {
    "target": "_team",
    "title": "Team",
    "description": "The team responsible for this issue",
    "required": false,
    "many": false
    }
  3. Click Save.

Add aggregation properties to the team blueprint

Now we will add aggregation properties to the _team blueprint to compute sprint health metrics from the related Jira issues.

  1. Go to your Builder page.

  2. Search for the Team blueprint (_team) and click on it.

  3. Click on the ... button in the top right corner, and choose {...} Edit JSON.

  4. Add the following aggregation properties:

    Sprint health aggregation properties (click to expand)
    "sprintIssuesTotal": {
    "title": "Sprint Issues (Total)",
    "icon": "DefaultProperty",
    "type": "number",
    "target": "jiraIssue",
    "query": {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    }
    ]
    },
    "calculationSpec": {
    "func": "count",
    "calculationBy": "entities"
    }
    },
    "sprintIssuesDone": {
    "title": "Sprint Issues (Done)",
    "icon": "DefaultProperty",
    "type": "number",
    "target": "jiraIssue",
    "query": {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    },
    {
    "property": "status",
    "operator": "=",
    "value": "Done"
    }
    ]
    },
    "calculationSpec": {
    "func": "count",
    "calculationBy": "entities"
    }
    },
    "sprintIssuesAddedMidSprint": {
    "title": "Sprint Issues (Added Mid-Sprint)",
    "icon": "DefaultProperty",
    "type": "number",
    "target": "jiraIssue",
    "query": {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    },
    {
    "property": "addedMidSprint",
    "operator": "=",
    "value": true
    }
    ]
    },
    "calculationSpec": {
    "func": "count",
    "calculationBy": "entities"
    }
    },
    "sprintIssuesCarriedOver": {
    "title": "Sprint Issues (Carried Over)",
    "icon": "DefaultProperty",
    "type": "number",
    "target": "jiraIssue",
    "query": {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    },
    {
    "property": "carriedOver",
    "operator": "=",
    "value": true
    }
    ]
    },
    "calculationSpec": {
    "func": "count",
    "calculationBy": "entities"
    }
    },
    "sprintStoryPointsTotal": {
    "title": "Sprint Story Points (Total)",
    "icon": "DefaultProperty",
    "type": "number",
    "target": "jiraIssue",
    "query": {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    }
    ]
    },
    "calculationSpec": {
    "func": "sum",
    "calculationBy": "property",
    "property": "storyPoints"
    }
    },
    "sprintStoryPointsDone": {
    "title": "Sprint Story Points (Done)",
    "icon": "DefaultProperty",
    "type": "number",
    "target": "jiraIssue",
    "query": {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    },
    {
    "property": "status",
    "operator": "=",
    "value": "Done"
    }
    ]
    },
    "calculationSpec": {
    "func": "sum",
    "calculationBy": "property",
    "property": "storyPoints"
    }
    }
  5. Click Save.

Add calculation properties for percentages

Aggregation properties give us the raw counts. To turn them into percentages, add calculation properties to the _team blueprint:

  1. In the Team blueprint JSON, click on the ... button in the top right corner, and choose {...} Edit JSON. Then add the following to the calculationProperties object:

    Sprint health calculation properties (click to expand)
    "sprintCompletionRate": {
    "title": "Sprint Completion Rate (%)",
    "icon": "Star",
    "type": "number",
    "calculation": "if .properties.sprintIssuesTotal > 0 then ((.properties.sprintIssuesDone / .properties.sprintIssuesTotal) * 100 | floor) else null end"
    },
    "sprintScopeChangePercent": {
    "title": "Sprint Scope Change (%)",
    "icon": "Alert",
    "type": "number",
    "calculation": "if .properties.sprintIssuesTotal > 0 then ((.properties.sprintIssuesAddedMidSprint / .properties.sprintIssuesTotal) * 100 | floor) else null end"
    },
    "sprintCarryoverRate": {
    "title": "Sprint Carryover Rate (%)",
    "icon": "Clock",
    "type": "number",
    "calculation": "if .properties.sprintIssuesTotal > 0 then ((.properties.sprintIssuesCarriedOver / .properties.sprintIssuesTotal) * 100 | floor) else null end"
    }
  2. Click Save.

Set up data source mapping

Update your Jira integration mapping to populate the new sprint health fields. The mapping uses the Jira sprint custom field to extract sprint name, state, and derived flags for mid-sprint additions and carryover.

  1. Go to your Data Sources page.

  2. Select your Jira integration.

  3. Update the issue resource mapping to include the sprint health properties:

    Issue mapping with sprint health fields (click to expand)
    - kind: issue
    selector:
    query: "true"
    jql: "sprint is not EMPTY AND ((statusCategory != Done) OR (updated >= -4w))"
    port:
    entity:
    mappings:
    identifier: .key
    title: .fields.summary
    blueprint: '"jiraIssue"'
    properties:
    url: (.self | split("/") | .[:3] | join("/")) + "/browse/" + .key
    status: .fields.status.name
    issueType: .fields.issuetype.name
    components: .fields.components
    creator: .fields.creator.emailAddress
    priority: .fields.priority.name
    labels: .fields.labels
    created: .fields.created
    updated: .fields.updated
    sprint: .fields.customfield_XXXXX[-1].name // ""
    sprintState: .fields.customfield_XXXXX[-1].state // null
    storyPoints: .fields.customfield_YYYYY // null
    addedMidSprint: >-
    (
    (.fields.customfield_XXXXX[-1].startDate // null) as $start |
    if $start != null then
    ((.fields.created[0:19] + "Z" | fromdateiso8601) > ($start[0:19] + "Z" | fromdateiso8601))
    else false end
    )
    carriedOver: >-
    (
    (.fields.customfield_XXXXX | length) as $count |
    if $count > 1 then
    (.fields.customfield_XXXXX[-2].state == "closed"
    and (.fields.status.statusCategory.key != "done"))
    else false end
    )
    relations:
    project: .fields.project.key
    parentIssue: .fields.parent.key
    subtasks: .fields.subtasks | map(.key)
    team: .fields.customfield_ZZZZZ.value // null
    Replace custom field IDs
    • Replace customfield_XXXXX with your Sprint field ID.
    • Replace customfield_YYYYY with your Story Points field ID.
    • Replace customfield_ZZZZZ with the field you use to assign teams (e.g. a custom "Team" field, or derive it from the assignee). Adjust the jq expression to match your Jira schema.
  4. Click Save & Resync.

After the resync completes, each team entity will display its sprint health metrics automatically.

Set up scorecard

Before building the dashboard, we will create a scorecard on the _team blueprint to assign maturity levels based on sprint health metrics. Setting this up first lets us include scorecard results in the dashboard widgets.

The levels reflect increasing discipline in sprint planning and execution:

LevelCriteria
BasicDefault level for all teams (no rules passed yet).
BronzeTeam has sprint data and completion rate > 60%.
SilverCompletion rate > 75% and scope change < 20%.
GoldCompletion rate > 90% and scope change < 10%.
  1. Go to your Builder page.

  2. Search for the Team (_team) blueprint and select it.

  3. Click on the Scorecards tab.

  4. Click on + New Scorecard.

  5. Click on the ... button in the top right corner, and choose {...} Edit JSON and paste this JSON configuration:

    Sprint health scorecard (click to expand)
    {
    "identifier": "sprintHealth",
    "title": "Sprint Health",
    "levels": [
    {
    "color": "paleBlue",
    "title": "Basic"
    },
    {
    "color": "bronze",
    "title": "Bronze"
    },
    {
    "color": "silver",
    "title": "Silver"
    },
    {
    "color": "gold",
    "title": "Gold"
    }
    ],
    "rules": [
    {
    "identifier": "hasSprintData",
    "title": "Has sprint data",
    "description": "The team has at least one issue associated with an active sprint",
    "level": "Bronze",
    "query": {
    "combinator": "and",
    "conditions": [
    {
    "property": "sprintIssuesTotal",
    "operator": ">",
    "value": 0
    }
    ]
    }
    },
    {
    "identifier": "completionAbove60",
    "title": "Completion rate above 60%",
    "description": "At least 60% of sprint issues are completed",
    "level": "Bronze",
    "query": {
    "combinator": "and",
    "conditions": [
    {
    "property": "sprintCompletionRate",
    "operator": ">",
    "value": 60
    }
    ]
    }
    },
    {
    "identifier": "completionAbove75",
    "title": "Completion rate above 75%",
    "description": "At least 75% of sprint issues are completed",
    "level": "Silver",
    "query": {
    "combinator": "and",
    "conditions": [
    {
    "property": "sprintCompletionRate",
    "operator": ">",
    "value": 75
    }
    ]
    }
    },
    {
    "identifier": "scopeChangeBelow20",
    "title": "Scope change below 20%",
    "description": "Fewer than 20% of sprint issues were added after the sprint started",
    "level": "Silver",
    "query": {
    "combinator": "and",
    "conditions": [
    {
    "property": "sprintScopeChangePercent",
    "operator": "<",
    "value": 20
    }
    ]
    }
    },
    {
    "identifier": "completionAbove90",
    "title": "Completion rate above 90%",
    "description": "At least 90% of sprint issues are completed",
    "level": "Gold",
    "query": {
    "combinator": "and",
    "conditions": [
    {
    "property": "sprintCompletionRate",
    "operator": ">",
    "value": 90
    }
    ]
    }
    },
    {
    "identifier": "scopeChangeBelow10",
    "title": "Scope change below 10%",
    "description": "Fewer than 10% of sprint issues were added after the sprint started",
    "level": "Gold",
    "query": {
    "combinator": "and",
    "conditions": [
    {
    "property": "sprintScopeChangePercent",
    "operator": "<",
    "value": 10
    }
    ]
    }
    }
    ]
    }
  6. Click Save.

After the scorecard evaluates, each team entity will display its sprint health maturity level. Teams can view their level in the Scorecards tab on their entity page and track progress toward higher levels.

Visualize sprint metrics

With sprint metrics and scorecard levels in place, let's build a team-level dashboard that surfaces the three core sprint health indicators i.e. completion rate, scope change %, and carryover rate alongside scorecard maturity levels.

Create the dashboard

  1. Navigate to the Catalog page.
  2. Click on the + button in the left sidebar.
  3. Select New dashboard.
  4. Name the dashboard Sprint Health.
  5. Set the description to Track sprint delivery metrics across teams.
  6. Select the Jira icon.
  7. Click Create.

Add widgets

Add high-level summary widgets

These widgets give a high-level picture of where teams stand right now.

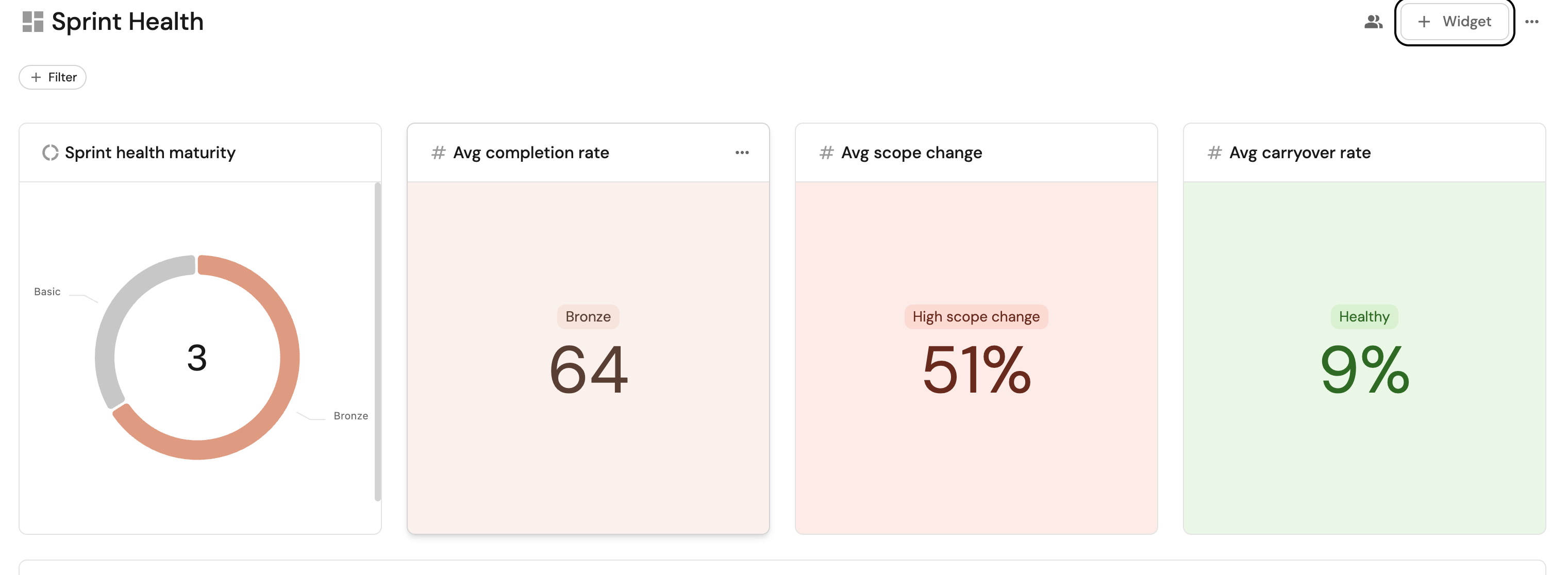

Scorecard maturity distribution (click to expand)

Shows how many teams are at each maturity level (Basic, Bronze, Silver, Gold).

  1. Click + Widget and select Pie Chart.
  2. Title: Sprint health maturity.
  3. Choose the Team (_team) blueprint.
  4. Under Breakdown by property, select the Sprint Health scorecard level.
  5. Click Save.
Average completion rate (click to expand)

A single number showing the organization-wide average sprint completion rate, with color thresholds aligned to the scorecard levels.

  1. Click + Widget and select Number Chart.
  2. Title: Avg completion rate.
  3. Select Aggregate by property as the chart type.
  4. Choose the Team (_team) blueprint.
  5. Select Sprint Completion Rate (%) for the Property.
  6. Set the Function to average.
  7. Select total for Average of.
  8. Select Round for Display formatting.
  9. Select custom as the Unit and input % as the custom unit.
  10. Add a condition: operator >=, value 90, color green, message Gold.
  11. Add a condition: operator >=, value 75, color blue, message Silver.
  12. Add a condition: operator >=, value 60, color orange, message Bronze.
  13. Add a condition: operator <, value 60, color red, message Below target.
  14. Click Save.
Average scope change (click to expand)

A single number showing the organization-wide average mid-sprint scope change.

  1. Click + Widget and select Number Chart.
  2. Title: Avg scope change.
  3. Select Aggregate by property as the chart type.
  4. Choose the Team (_team) blueprint.
  5. Select Sprint Scope Change (%) for the Property.
  6. Set the Function to average.
  7. Select total for Average of.
  8. Select Round for Display formatting.
  9. Select custom as the Unit and input % as the custom unit.
  10. Add a condition: operator <, value 10, color green, message Gold.
  11. Add a condition: operator <, value 20, color blue, message Silver.
  12. Add a condition: operator >=, value 20, color red, message High scope change.
  13. Click Save.
Average carryover rate (click to expand)

A single number showing how much unfinished work is carried between sprints.

  1. Click + Widget and select Number Chart.
  2. Title: Avg carryover rate.
  3. Select Aggregate by property as the chart type.
  4. Choose the Team (_team) blueprint.
  5. Select Sprint Carryover Rate (%) for the Property.
  6. Set the Function to average.
  7. Select total for Average of.
  8. Select Round for Display formatting.
  9. Select custom as the Unit and input % as the custom unit.
  10. Add a condition: operator <=, value 10, color green, message Healthy.
  11. Add a condition: operator >, value 20, color red, message High carryover.
  12. Click Save.

Add per-sprint trend widgets

These line charts track how each metric evolves over time, making it easy to spot regressions or improvements sprint over sprint.

Completion rate trend (click to expand)

Tracks the completion rate for all teams over successive sprints.

  1. Click + Widget and select Line Chart.
  2. Title: Completion rate trend.
  3. Select Aggregate property (all entities) as the chart type.
  4. Choose the Team (_team) blueprint.
  5. Under the Y axis:
    • Title: Completion rate (%).
    • Set the aggregation function to average.
  6. Under the X axis:
    • Title: Sprint.
    • Measure time by $updatedAt.
    • Set the time interval to Week (or match your sprint cadence).
    • Set the time range to Last 180 days.
  7. Click Save.
Scope change trend (click to expand)

Shows how mid-sprint scope change evolves across all teams over time.

  1. Click + Widget and select Line Chart.
  2. Title: Scope change trend.
  3. Select Aggregate property (all entities) as the chart type.
  4. Choose the Team (_team) blueprint.
  5. Under the Y axis:
    • Title: Scope change (%).
    • Choose the Sprint Scope Change (%) property.
    • Set the aggregation function to average.
  6. Under the X axis:
    • Title: Time.
    • Measure time by $updatedAt.
    • Set the time interval to Week.
    • Set the time range to Last 3 months.
  7. Click Save.
Carryover rate trend (click to expand)

Shows whether carryover is improving or worsening across teams over time.

  1. Click + Widget and select Line Chart.
  2. Title: Carryover rate trend.
  3. Select Aggregate property (all entities) as the chart type.
  4. Choose the Team (_team) blueprint.
  5. Under the Y axis:
    • Title: Carryover rate (%).
    • Choose the Sprint Carryover Rate (%) property.
    • Set the aggregation function to average.
  6. Under the X axis:
    • Title: Time.
    • Measure time by $updatedAt.
    • Set the time interval to Week.
    • Set the time range to Last 3 months.
  7. Click Save.

Add team comparison widgets

These widgets let you compare teams side by side and drill into the active sprint.

Sprint issues by status (click to expand)

A breakdown of all active sprint issues by their current status, showing how much work is done, in progress, or not yet started.

  1. Click + Widget and select Pie Chart.
  2. Title: Sprint issue status.
  3. Choose the Jira Issue blueprint.
  4. Under Breakdown by property, select Status.
  5. Add this filter to scope to the active sprint:
    [
    {
    "combinator": "and",
    "rules": [
    {
    "property": "sprintState",
    "operator": "=",
    "value": "active"
    }
    ]
    }
    ]
  6. Click Save.
Team sprint health table (click to expand)

A comparison table showing every team's scorecard level and all three sprint health metrics in one view.

  1. Click + Widget and select Table.
  2. Title: Team sprint health.
  3. Choose the Team (_team) blueprint.
  4. Click Save, then click the ... button on the widget and select Customize table.
  5. Click Manage Properties and add:
    • Sprint Health (scorecard level).
    • Sprint Completion Rate (%).
    • Sprint Scope Change (%).
    • Sprint Carryover Rate (%).
    • Sprint Issues (Total).
    • Sprint Issues (Done).
    • Sprint Story Points (Total).
    • Sprint Story Points (Done).
  6. Click the save icon to persist the table layout.

Next steps

  • Set up automations: Use Port automations to send Slack notifications when a team's sprint health drops below a threshold.
  • Compare across teams: Use the dashboard table widget with sorting and grouping to benchmark teams against each other.
  • Track story points alongside issue counts: Use the story point aggregation properties already configured to create a parallel set of story-point-based completion metrics for teams that estimate with points.
